After completing the sprint on an agile project, a team updates the risk burndown chart and notices that risk exposure has increased to levels that could negatively affect project completion. What should the risk manager do to return the project's risk exposure to an acceptable level?
-
A
Update the definition of done (DoD) to improve risk management.
-
B
Review the acceptance criteria for upcoming stories.
-
C
Prioritize risk mitigation stories for the next sprint.
-
D
Check stories in the product backlog to identify risks.
Reveal answer details
Close answer details
You are the project manager of the GHE Project. You have identified the following risks with the characteristics as shown in the following figure: How much capital should the project set aside for the risk contingency reserve?
-
A
-
B
-
C
-
D
Reveal answer details
Close answer details
While planning for project execution phase stakeholders are making decisions on how to respond to known and new risks. What artifact should the stakeholders prepare?
-
A
-
B
-
C
-
D
Reveal answer details
Close answer details
A project manager is developing the risk management process and schedules a risk planning workshop at the start of the project. Upon receiving the invitation, a senior stakeholder emails the project manager stating that a risk management plan is not needed since this is small project, and lack of a plan will reduce costs. Which of the following should the project manager do?
-
A
Advise the stakeholder that risk management is a valuable undertaking and must be applied to all projects to some degree.
-
B
Cancel the workshop as the stakeholder is senior and risk management is an optional process, especially on smaller projects.
-
C
Continue with the workshop, but remove the stakeholder from the list of attendees.
-
D
Review the scope in an attempt to save money in other areas of the project to provide funding for the risk management activities
Reveal answer details
Close answer details
In a large enablement project with strict time lines, risks need to be closely monitored. The risk manager publishes reports comparing planned enablement sessions with actual enablement sessions, which help identify potential risks to be addressed. Which technique is the risk manager using?
-
A
-
B
-
C
-
D
Reveal answer details
Close answer details
John is the project manager of the NHQ Project for his company. His project has 75 stakeholders, some of which are external to the organization. John needs to make certain that he communicates about risk in the most appropriate method for the external stakeholders. Which project management plan will be the best guide for John to communicate to the external stakeholders?
-
A
-
B
-
C
Communications Management Plan
-
D
Reveal answer details
Close answer details
A complex project that had hundreds of risks is almost done. The project manager is closing the risks as part of the closing process. One team member mentions that there are important documents to be updated. Which document will need to be updated?
-
A
-
B
-
C
-
D
Reveal answer details
Close answer details
A project team has completed the risk response plan for a newly identified major project risk. Some team members argue the plan does not totally eliminate the risk, considering the effort required to implement it, and feel the planned response should be thrown out altogether. What should the risk manager do in this situation?
-
A
Accept the response because there are no secondary risks were identified.
-
B
The response plan should be discontinued and the risk should be accepted and dealt with if it occurs.
-
C
Accept the residual risk as it is compatible with the organization's risk appetite.
-
D
All identified risks must be addressed because they might significantly impact the project if they occur.
Reveal answer details
Close answer details
A risk manager for a financial organization is assigned to support a project team in developing a custom software solution to manage loans. Which document should the risk manager request first from the project sponsor to identify major risks?
-
A
-
B
-
C
Organization's mission and vision
-
D
Historical data from the credit portfolio
Reveal answer details
Close answer details
Question 10
Single choice
The risk manager of a major project needs to ensure the organizational process assets (OPAsj are updated as a result of risk management activities. How will the risk manager accomplish this?
-
A
Ensuring that the project sponsor is kept well-informed
-
B
Arranging periodic risk: management process audits
-
C
Communicating the status of risks regularly to stakeholders
-
D
Monitoring costs with intervention when necessary
Reveal answer details
Close answer details
Question 11
Single choice
Product testing can be done in multiple ways. A few project team members suggest testing be done in a laboratory environment, whereas others recommend completing the analysis via simu-lation methods. The testing manager has consulted with a peer, who recommends undertaking testing using field trials. The testing manager consults with the risk manager to assess the risk involved in the testing. Which tool should the risk manager consider for assessing the test risk?
-
A
-
B
-
C
Probability and impact matrix
-
D
Reveal answer details
Close answer details
Question 12
Single choice
A two-year project with a budget of US$2 million has completed about 60% of the work at the end of the first year. The actual cost incurred to complete the remaining 40% of work is about USS1.5 million. As a part of performing a specialized risk analysis, the calculated schedule performance index (SPI) is 1.2 and cost performance index (CPI) is 0.53. How should the risk manager interpret such a low CPI value?
-
A
The cost control processes is ineffective.
-
B
The cost baseline is inaccurate.
-
C
The actual reported costs are inaccurate.
-
D
The cost related risks are effectively managed.
Reveal answer details
Close answer details
Question 13
Single choice
Rex is the project manager of the BDF Project. This project will last for two years and has a budget of $2,345,000. Management has instructed Rex that the project must not go over budget as funds are very tight in the organization. During the project planning Rex and the project team discover a positive risk event to save $75,000. Rex wants to make certain that this risk event happens so which risk response method is most appropriate?
-
A
-
B
-
C
-
D
Reveal answer details
Close answer details
Question 14
Multiple choice
A new risk manager has been hired on a project and meets with the project director. The project director supplies the project's risk register and asks the risk manager for an analysis of its effectiveness. What two actions should the risk manager do next? (Choose two.)
-
A
Check to ensure that the risk is supported by a Monte Carlo simulation.
-
B
Check to ensure that the risks are gathered using Delphi technique.
-
C
Check for risk classification and that probability and impact are identified.
-
D
Check to ensure that risk origin, triggering event, and ownership is identified.
-
E
Check to ensure the risk meeting agenda and supporting documents are distributed.
Reveal answer details
Close answer details
Question 15
Single choice
Which of the following components ensures that risks are examined for all new proposed change requests in the change control system?
-
A
Risk monitoring and control
-
B
-
C
Integrated change control
-
D
Reveal answer details
Close answer details
Question 16
Single choice
A risk manager is tasked with establishing a risk management strategy for a multinational project with varying regulations and stakeholder priorities. The team is divided on how to approach risk management. Some suggest implementing rigid procedures to ensure consistency across regions, while others advocate for a flexible approach to adapt to the dynamic nature of local risks. Meanwhile, the sponsor emphasizes the need for a strategy that aligns with the overall project objectives. What should the risk manager do?
-
A
Implement a strict, standardized approach to ensure consistency across all regions.
-
B
Develop a strategy combining structure with flexibility to address global and local uncertainties.
-
C
Use organizational guidelines to create a strategy that prioritizes efficiency over adaptability.
-
D
Adopt a fully flexible approach that allows teams to manage issues based on local context.
Reveal answer details
Close answer details
Question 17
Single choice
A project manager is working on a complex construction project. During the risk identification process, hundreds of risks were identified. The team seems to be confused regarding on which risks to focus. The project manager advises the team to go ahead and start assessing the likelihood and impact of each risk. What process is this part of?
-
A
-
B
Perform Qualitative Risk Analysis
-
C
Perform Quantitative Risk Analysis
-
D
Reveal answer details
Close answer details
Question 18
Single choice
You are the project manager of the NHQ Project for your company. You are discussing some of the project issues that need to be resolved in the project. You and the project stakeholders come to an agreement about the risk issues and how they will be resolved. Where should you document this information for issue resolution?
-
A
Project management plan for execution
-
B
Lessons learned documentation
-
C
-
D
Reveal answer details
Close answer details
Question 19
Single choice
Harry works as a project manager for the NHQ Project. He is performing quantitative risk analysis for his project. One of the project risks has a 40 percent probability of happening, and it will cost the project $65,000 if the risk happens. What is the expected monetary value of this risk event?
-
A
-
B
-
C
Zero - the risk event has not yet occurred
-
D
Reveal answer details
Close answer details
Question 20
Multiple choice
The project manager asks the risk manager to determine the initial risk assessment for a six month initiative that is about to kick-off. Which two artifacts will help the risk manager conduct the related analysis? (Choose two.)
-
A
Work breakdown structure (W&S)
-
B
Project organizational chart
-
C
Configuration management plan
-
D
-
E
Reveal answer details
Close answer details
Question 21
Single choice
A risk manager is facilitating a risk identification workshop on a new product with technical experts. There is no consensus among the technical experts on most of the identified risks and their characteristics. The risk manager decides to resolve this difference using another technique. Which technique should the risk manager use in this situation?
-
A
-
B
-
C
-
D
Reveal answer details
Close answer details
Question 22
Single choice
Linda is the project manager of the NAB Project. One of the risks her project team has identified is too dangerous for the project team to manage internally so she has hired a vendor to complete this portion of the project and to manage the identified risk. What risk response has Linda used in this instance?
-
A
-
B
-
C
-
D
Reveal answer details
Close answer details
Question 23
Single choice
During the design phase the project team is exploring various architecture options. After reviewing the results of design pilot, two conflicting infrastructure pieces were identified. What action should the project manager take?
-
A
Reassess the design for the two pieces.
-
B
Escalate the situation and request approval to move forward.
-
C
Confirm the results through a second pilot.
-
D
Update the assumptions log and assess the risk associated with it.
Reveal answer details
Close answer details
Question 24
Single choice
While performing risk identification exercises, the risk manager often encounters biases from the project team. How can the risk manager accurately identify what will trigger a risk?
-
A
Remind the project team to keep an open mind
-
B
Review the results with the project manager afterward
-
C
Review published operational experience reports
-
D
Use the mean answers provided by the project team
Reveal answer details
Close answer details
Question 25
Single choice
A project team has just completed a project plan, which includes extra days for most of the critical activities to cover any possible issues. Stakeholders want to remove these additional days, because the end date is longer than expected. What should the risk manager do first?
-
A
Remove the activity padding.
-
B
Review the risk response plan.
-
C
Update the risk contingency plan.
-
D
Update the schedule constraints.
Reveal answer details
Close answer details
Question 26
Single choice
Examine the figure given below.  What will be the expected monetary value of Risk C?
-
A
-
B
$175,000 if the risk event actually happens
-
C
-
D
Reveal answer details
Close answer details
Question 27
Single choice
Which of the following would a proactive risk manager do during the Monitoring and Controlling Process?
-
A
Develop risk responses, create risk management plan, and stay alert for risk events.
-
B
Update the lessons learned documents, develop risk responses, and create the risk management plan.
-
C
Review identified risks, stay alert for risk events, and remind team members to keep the risk manager informed about risk triggers.
-
D
Review lessons learned document to identify risks, quantity risks, and lower impact ratings.
Reveal answer details
Close answer details
Question 28
Single choice
A company is executing a high-visibility project to develop mobile phone technology. The project sponsor is concerned that an overall high risk rating may undermine support for the project within the company. The sponsor has instructed the project manager to manipulate the data used for Monte Carlo simulation to artificially reduce the risk rating. What should the project manager do?
-
A
Schedule a face-to-face meeting with the project sponsor.
-
B
-
C
-
D
Email the project sponsor explaining why the data should not be modified.
Reveal answer details
Close answer details
Question 29
Single choice
At the completion of a small project, the risk manager performs a risk audit and finds that several identified risks had occurred, and the impact was significantly larger than expected. While the project remained on schedule, the project budget increased by 50%. The project met all risk response milestones and no additional, previously unidentified risks, occurred on the project. Based on this information, what risk management process improvement should the risk manager recommend for future similar projects?
-
A
Increase frequency of risk management meetings with the project manager.
-
B
Revise the level of accuracy of probability and impact scores.
-
C
Document the risk audit report and capture it in the lessons learned database.
-
D
Expand the use of risk identification techniques.
Reveal answer details
Close answer details
Question 30
Single choice
Ned is the project manager of the HNN project for your company. Ned has asked you to help him complete some probability distributions for his project. What portion of the project will you most likely use for probability distributions?
-
A
Bias towards risk in new resources
-
B
Risk probability and impact matrixes
-
C
-
D
Uncertainty in values such as duration of schedule activities
Reveal answer details
Close answer details
Question 31
Single choice
Which of the following processes involves choosing the alternative strategies, executing a contingency or fallback plan, taking corrective action, and modifying the project management plan?
-
A
-
B
-
C
Integrated Change control
-
D
Reveal answer details
Close answer details
Question 32
Single choice
A project team is concerned about a risk which, if occurs, might add additional complexity to their work. The team will need help from an external vendor, but the contracting process is long. What should the risk manager do in this case?
-
A
Document the risk in the risk register for analysis.
-
B
Document the detailed risk consequences,
-
C
Immediately start the contracting process.
-
D
Proceed with the quantitative risk analysis.
Reveal answer details
Close answer details
Question 33
Single choice
An organization faces immense competition in the market and decides 10 accelerate a key project. What is the first action for the project risk manager to take?
-
A
Ensure sufficient resources are available
-
B
Revise the risk management plan
-
C
-
D
Meet with the project's stakeholders
Reveal answer details
Close answer details
Question 34
Single choice
The scope of a large mobile network deployment project includes equipment to be furnished by the customer. The risk manager is concerned that the equipment delivery might be delayed, causing additional delays in the project. What should the risk manager do?
-
A
Follow up on the schedule and assess the best course of action if any delays are detected.
-
B
Ensure the equipment constraint is well-documented and manage it as a high-impact project risk.
-
C
Raise the issue with the project sponsor so it can be handled as a sales or contractual matter.
-
D
Obtain a signed commitment from the customer that equipment will be delivered on time.
Reveal answer details
Close answer details
Question 35
Single choice
You are the project manager of your organization. Your organization will receive a bonus if the project finishes by December 20. Management has communicated this bonus to you and your project team and has asked you to evaluate the project to see if it is possible to realize the reward. The bonus offered to your organization is $750,000. You have examined the project and believe that you can crash the project for an additional $275,000 and reach the December 20 date. Management is thrilled with your assessment and they approve the crash fee. What risk response is this?
-
A
Crashing can be a type of the enhancing risk response.
-
B
Crashing can be considered transference because of the $275,000 is actually paid from the bonus, which is paid by the project customer.
-
C
Crashing can be a type of the exploit risk response.
-
D
Crashing is the addition of labor, not a risk response.
Reveal answer details
Close answer details
Question 36
Single choice
In a large industrial business, an on-going system development project faces a previously identified risk. The risk is adequately managed by the risk manager, however there is still residual risk. What should the risk manager do?
-
A
Update the risk register accordingly and review it in regular project meetings.
-
B
Accept the risk because residual risks are often low.
-
C
Ask a subject matter expert (SME) to assess the residual risk and take action.
-
D
Assign a risk owner and set it as high priority and high impact.
Reveal answer details
Close answer details
Question 37
Single choice
John works as a project manager for BlueWell Inc. He is determining which risks can affect the project. Which of the following inputs of the identify risks process is useful in identifying risks associated to the time allowances for the activities or projects as a whole, with a width of the range indicating the degrees of risk?
-
A
Activity duration estimates
-
B
-
C
-
D
Reveal answer details
Close answer details
Question 38
Single choice
A project manager wants to represent the distribution of uncertainty around a risk model element. However, good data on the variability, of the risk model element has not been collected, and only contains minimum and maximum values. What curve should the project manager use to represent the distribution?
-
A
-
B
-
C
-
D
Reveal answer details
Close answer details
Question 39
Single choice
A project team member identifies, but does not document, a risk early in the project, because it is considered to be trivial. This risk occurs later and negatively impacts the project. What could the project manager do to avoid this situation?
-
A
Conduct team meetings early in the project to ensure team member are familiar with risk identification requirements.
-
B
Communicate the punishment and rewards policy to the project team during the project kick-off meeting.
-
C
Provide project team members with access to simulation tools and decision tree diagrams.
-
D
Provide team members with a risk management prompt list early in the project to ensure risks are not missed.
Reveal answer details
Close answer details
Question 40
Single choice
Ben is the project manager of the CMH Project for his organization. He has identified a risk that has a low probability of happening, but the impact of the risk event could save the project and the organization with a significant amount of capital. Ben assigns Laura to the risk event and instructs her to research the time, cost, and method to improve the probability of the positive risk event. Ben then communicates the risk event and response to management. What risk response has been used here?
-
A
-
B
-
C
-
D
Reveal answer details
Close answer details
Question 41
Single choice
A project manager is running a high-cost telecommunications project. There is a monthly status meeting, and the risk manager should provide an update to the project team and project sponsors on major risks. What risk related information should be included in the monthly status meeting of this complex project?
-
A
Top priority risks at present, risks closed in the last period, milestone changes
-
B
Top priority risks at present, risks that have occurred, risk management plan
-
C
Top priority risks at present, risks that have occurred, changes in scope
-
D
Top priority risks at present, risks that have occurred, risks closed in the last period
Reveal answer details
Close answer details
Question 42
Single choice
PESTLE, TECOP, and SPECTRUM are three examples of prompt lists that can be used during risk management activities. Prompt lists are used to do which of the following?
-
A
Simulate risk identification.
-
B
Perform a simulation with all prompted risks varying simultaneously.
-
C
Identity basic causes of risks of more fundamental forces.
-
D
Achieve the relative weighting of the risks.
Reveal answer details
Close answer details
Question 43
Single choice

 Based on this information, which of the following has the highest risk exposure?
-
A
-
B
-
C
-
D
Reveal answer details
Close answer details
Question 44
Single choice
A risk manager is managing risks in a project. During the initial stages of project execution, a new risk is identified. There is a very small chance that this risk will occur and even if it occurs, the impact would be low. What should the risk manager do with this risk?
-
A
Put the risk on the watch list.
-
B
Seek guidance from subject matter experts (SMEs).
-
C
Ignore this risk as it is not critical.
-
D
Inform the stakeholders about this risk.
Reveal answer details
Close answer details
Question 45
Single choice

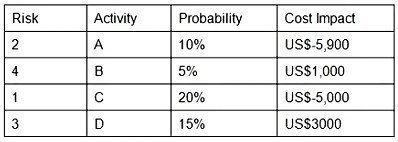

 A project has four risks that are identified during the risk identification process. The table shows the probability of each risk occurring and the corresponding cost. What is the total estimated monetary value of cost for this project?
-
A
-
B
-
C
-
D
Reveal answer details
Close answer details
Question 46
Single choice
A risk management professional is currently facilitating the risk planning process with the project team. To increase the breadth of considered risks, the team wants to include high-level and strategic project risks. What should the risk management professional do next?
-
A
Perform a sensitivity analysis to the higher-level aggregate activities
-
B
Develop a risk breakdown structure (RBS) identifying the potential risk categories
-
C
Conduct a strengths, weaknesses, opportunities, and threats (SWOT) analysis
-
D
Perform a base line Monte Carlo simulation to address overall threats to project objectives
Reveal answer details
Close answer details
Question 47
Single choice
You are the project manager of the NNQ Project for your company and are working with your project team to define contingency plans for the risks within your project. Mary, one of your project team members, asks what a contingency plan is. Which of the following statements best defines what a contingency response is?
-
A
Some responses are designed for use only if certain events occur.
-
B
Some responses have a cost and a time factor to consider for each risk event.
-
C
Some responses must counteract pending risk events.
-
D
Quantified risks should always have contingency responses.
Reveal answer details
Close answer details
Question 48
Single choice
A risk manager for a cross-functional project is initiating the risk identification process. The risk manager conducted some meetings for stakeholders to express their concerns, but some stakeholders are complaining that their opinions were not considered. How should the risk manager address these concerns?
-
A
Refer to the requirements documentation to confirm stakeholder requirements as they relate to risks.
-
B
Refer to the project charter to find guidelines and stakeholder communication channels.
-
C
Review the stakeholder register and stakeholder engagement plan to communicate and solicit stakeholder input.
-
D
Rewrite the risk register to include the additional possible risks and inform the stakeholders.
Reveal answer details
Close answer details
Question 49
Single choice
A risk manager administered a pre-workshop risk survey in preparation for the upcoming workshop. The workshop invitees participated in the survey and submitted many risks encompassing all project phases and risk areas. The risk manager sorts risks by similarities and categories for the workshop. What should the risk manager do next to visually organize the risks?
-
A
Develop an affinity diagram
-
B
Perform the analytical hierarchy process
-
C
-
D
Assign probability and impact
Reveal answer details
Close answer details
Question 50
Single choice
Joyce is the project manager for her company. Joyce and her project team are working through the quantitative analysis for certain risk events within her project. According to the enterprise environmental factors the project manager is to perform sensitivity analysis on any risk with an impact greater than $5,000 in the project. What is the sensitivity analysis?
-
A
It determines which risk events have the most potential impact on the project.
-
B
It uses round of anonymous surveys to predict which events are most likely to happen.
-
C
It uses rounds of anonymous surveys to predict probability and impact.
-
D
It determines possible combinations of risk events to predict overall project success, failure, or probability of achieving project objectives.
Reveal answer details
Close answer details
Question 51
Single choice
In addition to monitoring and controlling the project risks for their status and information the risk monitoring and controlling process accomplishes four key things for a project. Which one of the following is NOT a determination that is made by the risk monitoring and controlling process?
-
A
Determines if the project assumptions are still valid
-
B
Determines if the risk management policies and procedures are being followed
-
C
Determines if the risk contingency reserves should be modified to be in alignment with the current risk assessment
-
D
Determines if the project constraints are still valid
Reveal answer details
Close answer details
Question 52
Single choice
The company is a risk seeking organization, and has experienced measurable success based on their current strategy for growth. A new project has an overall project risk that exceeds the risk levels documented in the risk management plan. What would be the best course of action for the company to take with the project based on its current scope?
-
A
Monitor ongoing risks closely for any major changes.
-
B
Perform a Monte Carlo simulation to understand possible risk outcomes.
-
C
Cancel the project, as the overall level of risk remains unacceptable.
-
D
Conduct a stakeholder meeting to validate stakeholder risk appetite.
Reveal answer details
Close answer details
Question 53
Single choice
In a large mobile network deployment project, there is delay risk due to insufficient staffing. The risk manager is considering executing a response plan, which involves allowing staff members to work overtime. However, this action may lead to excessive additional cost. What should the risk manager do?
-
A
Document the concern over the potential excessive additional cost.
-
B
Manage the potential excessive additional cost as a new risk.
-
C
Ensure the project sponsor has the risk appetite for the residual risk created by allowing overtime.
-
D
Prepare a detailed response plan for the residual risk with a clear owner and time line to ensure there are no impacts to the project.
Reveal answer details
Close answer details
Question 54
Single choice
A risk manager on an infrastructure project gathers and analyzes performance data. The risk manager wants to identify which variables will impact the schedule and determine how these factors interact. Which data analysis tool should the risk manager use to forecast future performance?
-
A
-
B
What-if scenario analysis
-
C
-
D
Reveal answer details
Close answer details
Question 55
Single choice
A project team identified some risks in a project. Team members became interested in predicting the outcomes of their potential choices following their probability of occurrence. Which technique should the risk manager use?
-
A
Political, economic, social, technological, legal, and environmental (PESTLE) analysis
-
B
Strengths, weaknesses, opportunities, and threats (SWOT) analysis
-
C
-
D
Reveal answer details
Close answer details
Question 56
Single choice
John works as a project manager for ABD project. He and his team, are working on the following activities: 1. Relative ranking or priority list of project risks 2. Watchlists of low priority risk 3. Trends in Qualitative Risk Analysis results On which of the following processes is John working on?
-
A
Perform Qualitative Risk Analysis
-
B
-
C
-
D
Perform Quantitative Risk Analysis
Reveal answer details
Close answer details
Question 57
Single choice
The project risk manager is in the process of identifying risks. The project sponsor has communicated that there is an influential stakeholder who has a senior management position. The other stakeholders do not feel comfortable speaking in front of this stakeholder. What should the project risk manager do next to identify risks?
-
A
Review the risk breakdown structure to ensure project scope is covered.
-
B
Use the brainstorming technique to remove personal bias.
-
C
Use expert judgment to remove ego or emotional conflict.
-
D
Consider the Delphi technique to gather all stakeholder opinions.
Reveal answer details
Close answer details
Question 58
Single choice
Which of the following risk responses delineates that the project plan will not be changed to deal with the risk?
-
A
-
B
-
C
-
D
Reveal answer details
Close answer details
Question 59
Multiple choice
A risk manager for a new product development project has worked diligently with stakeholders and the project team to identify and document risks. These project risks vary widely in probability and impact. Which three actions should the risk manager take to inform the identification of resource requirements for individual risk responses? (Choose 3).
-
A
Work with the project team to conduct a decision tree analysis for each risk or set of related risks.
-
B
Calculate the expected monetary value (EMV) of each risk and use these outputs to inform and defend project reserves.
-
C
Conduct a Monte Carlo simul-ation to understand the probabilities of various risk outcomes.
-
D
Use the risk breakdown structure (RBS) to calculate the total cost of mitigating all risks and ensure project reserves are adequate to cover this amount.
-
E
Focus attention and resources on identified risks with the highest potential to impact the project.
Reveal answer details
Close answer details
Question 60
Single choice
During a status meeting, a functional manager complains that the server backup failed, impacting the department. This was a known risk documented in the risk register as an accepted risk. After reviewing the meeting minutes, itis determined that the functional manager had not participated in the risk planning phase. Which of the identification methods should have been applied?
-
A
-
B
-
C
-
D
Reveal answer details
Close answer details
Question 61
Single choice
What are the supporting elements for effective risk management?
-
A
Trained core people, matrix organization, simple scalable process, and tools and techniques
-
B
Competent people, collaborative organization, rigorous process, and tools and techniques
-
C
Competent people, supportive organization, simple scalable process, and tools and techniques
-
D
Competent people, functional organization, policy, and tools and techniques
Reveal answer details
Close answer details
Question 62
Single choice
A project is in the execution phase and involves large volumes of supplies. The project is the last phase of a 10-year initiative. The project sponsor asks the project manager to provide the performance report for the whole initiative. Which analysis should the risk manager do to provide the project manager with the performance report?
-
A
-
B
-
C
-
D
Reveal answer details
Close answer details
Question 63
Single choice
Tom is the project manager of the GGG project for his company. He is working with the project team on the Perform Qualitative Risk Analysis process. Tom is having the project team to review the project scope statement as an input to the qualitative risk analysis process. Why?
-
A
The project scope statement must be understood to see the project requirements and the inherent risks of the project.
-
B
The project scope statement will reveal the type of project as either a recurrent or first-of-its-kind project.
-
C
The project scope identifies the risks associated with project constraints.
-
D
The project scope statement must be reviewed to understand the quality requirements and the risks associated with the demand for quality.
Reveal answer details
Close answer details
Question 64
Single choice
You are the project manager of the NJJ project. Your enterprise environmental factors require that you establish certain risk management rules regarding low risks within your project. What is the best policy for risks with low probability and low impact in the project management?
-
A
These risks should be accepted.
-
B
These risks should be placed on a watchlist for future monitoring.
-
C
These risks should be identified, but dismissed.
-
D
These risks should be placed in the risk register.
Reveal answer details
Close answer details
Question 65
Single choice
When monitoring the execution quality of risk-related plans and processes, which of the following would be a useful metric to track and record?
-
A
The number of risks in the project register
-
B
The degree of variation from the baseline
-
C
The number of levels in the risk breakdown structure
-
D
The degree of variation from the risk response strategy
Reveal answer details
Close answer details
Question 66
Single choice
A new resource is added to the project team from a matrix organization. How should the project's risk manager familiarize the new team member with the project's risk management process?
-
A
The functional manager is responsible for providing the training.
-
B
Provide project specific risk training and mentor through the risk process.
-
C
Send the new team member the risk management plan to read.
-
D
Provide the new team member with a copy of the risk register and latest status report.
Reveal answer details
Close answer details
Question 67
Single choice
An organization is embarking on a multi-million-dollar project with numerous identified risks. What should the project risk team do to navigate the risks on this project?
-
A
Go for a low-risk threshold of ?% around a cost objective.
-
B
Confirm stakeholders risk thresholds based on risk appetites.
-
C
Conduct risk identification to populate the risk register.
-
D
Go for a high-risk threshold of ?0% around a cost objective.
Reveal answer details
Close answer details
Question 68
Single choice
The stakeholders of a building construction project are not comfortable with the project manager's handling of the project as they believe there is a financial risk. The project manager asks the risk manager to assist in demonstrating to the stakeholders that the project risks are under a tolerable threshold. What should the risk manager do first to demonstrate this to the stakeholders?
-
A
Gather other project risk historical information.
-
B
Gather and reconcile project risk report data.
-
C
Work with the sponsor to convince the risks are under control.
-
D
Work with the team to ensure the project is in good health.
Reveal answer details
Close answer details
Question 69
Single choice
A risk manager has been assigned to replace a risk manager on sick leave. The new risk manager notices that the risk register is missing data that are key to the risk management process. Which data will the risk manager require first?
-
A
Risk description risk response, and quantitative data
-
B
Project plan, risk complexity, and secondary risk
-
C
Project plan, risk priority, and tool availability
-
D
Risk description, risk probability, and risk impact
Reveal answer details
Close answer details
Question 70
Single choice
David is the project manager of the NKL Project for his organization. He has been asked to create a proposal for a construction project for a client. David realizes that there are several requirements within the SOW and RFP provided by the client that would eliminate his company from bidding on the construction project. David proposed to management that his organization create a partnership with a competitor so that together they could bid on the construction project and qualify for the customer's requirements. What risk response is David proposing to management?
-
A
-
B
-
C
-
D
Reveal answer details
Close answer details
Question 71
Single choice
The project enters a testing phase to validate a project requirement. The testing is occurring in a common company testing area maintained by operations. The project team accepts the external customer's additional testing requirements, which may cause a slip in the schedule. A risk is identified, added to the risk register, and a response is developed. What is the next step to be completed?
-
A
Inform the external customer that the project manager has added the schedule risk to the register.
-
B
Hire more resources to ensure the original schedule is maintained.
-
C
Communicate and monitor the risk response with testing and operations.
-
D
Resist the customer's scope increase to maintain the original testing requirements.
Reveal answer details
Close answer details
Question 72
Single choice
A project is In the initiation phase. The project stakeholders are Invited to a meeting to share their thoughts that may impact the project In a positive or negative way. What will be the main output of this meeting?
-
A
Evaluating the project's probability of success
-
B
Identifying threats and opportunities
-
C
Evaluating the project's impact
-
D
Performing a qualitative analysis
Reveal answer details
Close answer details
Question 73
Single choice
A project manager has determined that they cannot outsource work nor eliminate the scope. They also discover that they cannot buy insurance or mitigate the risk. What should the project manager do?
-
A
-
B
-
C
-
D
Reveal answer details
Close answer details
Question 74
Single choice
A risk manager is conducting a qualitative risk analysis for a renewable energy project that faces tight deadlines. The team identifies risks such as weather unpredictability, material cost fluctuations, and potential regulatory delays. While some members advocate prioritizing high-likelihood risks, others emphasize addressing unlikely but high-impact risks. What should the risk manager do?
-
A
Focus on high-probability concerns first to proactively address the most immediate threats.
-
B
Delegate the assessment of lower-priority concerns to team leads while addressing critical ones.
-
C
Evaluate all identified concerns and consider likelihood and impact to prioritize the concerns effectively.
-
D
Prioritize uncertainties that align closely with the project's primary deliverables.
Reveal answer details
Close answer details
Question 75
Single choice
You are the project manager for BlueWell Inc. Your current project is a high priority and high profile project within your organization. You want to identify the project stakeholders that will have the most power in relation to their interest on your project. This will help you plan for project risks, stakeholder management, and ongoing communication with the key stakeholders in your project. In this process of stakeholder analysis, what type of a grid or model should you create based on these conditions?
-
A
Stakeholder power/interest grid
-
B
-
C
-
D
Reveal answer details
Close answer details
Question 76
Single choice
Shelly is the project manager of the BUF project for her company. In this project Shelly needs to establish some rules to reduce the influence of risk bias during the qualitative risk analysis process. What method can Shelly take to best reduce the influence of risk bias?
-
A
Group stakeholders according to positive and negative stakeholders and then complete the risk analysis
-
B
Determine the risk root cause rather than the person identifying the risk events
-
C
Establish risk boundaries
-
D
Establish definitions of the level of probability and impact of risk event
Reveal answer details
Close answer details
Question 77
Single choice
Who is responsible for the stakeholder expectations management in a high-profile, high-risk project?
-
A
Project risk assessment officer
-
B
Project management office
-
C
-
D
Reveal answer details
Close answer details
Question 78
Single choice
A new risk manager has been assigned to a project experiencing delays, quality issues, low performance, and client complaints. The work is being completed with the client's vendor, which apparently has been causing all of the issues. What should the risk manager do first?
-
A
Enhance risk identification.
-
B
Review the contingency reserves.
-
C
Create a risk response plan.
-
D
Review the risk registry.
Reveal answer details
Close answer details
Question 79
Single choice
When processing freight invoices for a project, the project manager notices the shipping costs exceeded the budget due to increased fuel costs. The risk manager included this risk in the project's contingency allowance. When reviewing the project budget execution reports, the project manager notices unused budget remaining in other closed tasks of the project that could cover the additional shipping costs. What should the project manager do?
-
A
Process the freight invoices at higher shipping costs against the project's contingency allowance.
-
B
Request a formal change order from the customer to increase the project's total budget.
-
C
Process the freight invoices for the budgeted amount and hope the shipping company will forgive the difference.
-
D
Ask the project sponsor to cover the additional shipping costs on the company's reserves account.
Reveal answer details
Close answer details
Question 80
Single choice
What identification technique is used to help reduce the ambiguity of a risk statement?
-
A
-
B
-
C
-
D
Reveal answer details
Close answer details
Question 81
Single choice
You are the project manager of the GGK project for your company. The GGK project has a budget of $1,265,100 and is currently 40 percent complete. In this project, you elected to add labor to the project to increase the likelihood of completing the project early as the project was only scheduled to be 35 percent complete at this time. This positive risk response, while keeping the project ahead of schedule, has added significant costs to the project. You have already spent $575,000 to reach this point in the project. Management would like to know what your cost performance index and the schedule performance index is for this project. What are these values?
-
A
The CPI is -$68,960 and the SPI is $63,255.
-
B
The CPI is .88 and the SPI is zero.
-
C
The CPI is .88 and the SPI is 1.14.
-
D
The CPI is 1.14 and the SPI is .88.
Reveal answer details
Close answer details
Question 82
Single choice
A risk manager completed risk response planning for a project that is currently in the execution phase. During a periodic review of the risk register, the project manager recognizes that some key secondary risks have not been considered. Who should the project manager hold accountable for missing the risks?
-
A
-
B
-
C
-
D
Reveal answer details
Close answer details
Question 83
Single choice
Ben is the project manager of the YHT Project for his company. Alice, one of his team members, is confused about when project risks will happen in the project. Which one of the following statements is the most accurate about when project risk happens?
-
A
Project risk can happen at any moment.
-
B
Project risk happens throughout the project execution.
-
C
Project risk is always in the future.
-
D
Project risk is uncertain, so no one can predict when the event will happen.
Reveal answer details
Close answer details
Question 84
Single choice
Ted is the project manager of the HRR project for his company. Management has asked that Ted periodically reviews the contingency reserve as risk events happen, pass, or are still pending. What is the purpose of reviewing the contingency reserve?
-
A
It helps to evaluate if the remaining reserve is adequate for the risk exposure.
-
B
It helps to determine how much more funds will need to be invested in the project.
-
C
It helps to evaluate secondary and residual risks related to the risk responses and their costs.
-
D
It helps to determine the probability and impact of project risks.
Reveal answer details
Close answer details
Question 85
Single choice
You and your project team have identified the project risks and now are analyzing the probability and impact of the risks. What type of analysis of the risks provides a quick and high-level review of each identified risk event?
-
A
A risk probability-impact matrix
-
B
Quantitative risk analysis
-
C
-
D
Qualitative risk analysis
Reveal answer details
Close answer details
Question 86
Single choice
A project is evaluating a new software to streamline the current purchase order process. The current process is labor-intensive and involves printing, ink signatures, scanning, and emailing. Several team members gathered cycle time data to gauge the current process and evaluate the new process. What should the risk manager do next with the data set?
-
A
Perform a probability and impact assessment
-
B
Perform Monte Carlo simulations
-
C
Perform a sensitivity analysis
-
D
Perform a risk data quality assessment
Reveal answer details
Close answer details
Question 87
Single choice
During what process should a project manager assign a risk owner?
-
A
-
B
-
C
-
D
Reveal answer details
Close answer details
Question 88
Single choice
A project to deploy a new technology in field offices across the country has just been initiated. Some stakeholders are not supportive of this project because their teams will potentially be impacted by staff reductions once the technology is implemented. How should the risk manager address this concern?
-
A
Invite these stakeholders to regular meetings to engage them in the definition of project assumptions.
-
B
Identify new stakeholders who might replace those involved thus far and are more closely aligned to the project goals.
-
C
Review the risk thresholds to potentially accommodate the concerns raised by these stakeholders.
-
D
Perform a stakeholder analysis to determine their interests and how they should be taken into account.
Reveal answer details
Close answer details
Question 89
Single choice
The risk register is developed during the initial phases of a virtualized desktop deployment. The register is reviewed by peers, responses are planned, reviewed again, and risks are prioritized. After project completion, the risk register is reviewed as part of the formal lessons learned process. During the review, itis realized that the risk register was not updated, and many responses were not executed during the deployment. Which of the following options should have been performed during the execution of the project?
-
A
Risk monitoring and control process
-
B
-
C
-
D
Reveal answer details
Close answer details
Question 90
Single choice
A project manager was informed that the testing of the latest component in the project's software update release was not successful. As a result, 1he delivery timelines for the software release wifi be delayed, The project manager did not previously capture this as a risk to the project. What should the project manager do next to avoid similar risks?
-
A
Add contingencies to other tasks to mitigate similar risks.
-
B
Reassess risks with a new assumptions and constraints analysis.
-
C
Review the risk response plan looking for lessons learned.
-
D
Log the event in the issue log and update the project management plan.
Reveal answer details
Close answer details
Question 91
Single choice
Kelly is the project manager of the NNQ Project for her company. This project will last for one year and has a budget of $350,000. Kelly is working with her project team and subject matter experts to begin the risk response planning process. When the project manager begins the plan risk response process, what two inputs will she need?
-
A
Risk register and the risk response plan
-
B
Risk register and power to assign risk responses
-
C
Risk register and the risk management plan
-
D
Risk register and the results of risk analysis
Reveal answer details
Close answer details
Question 92
Single choice
Towards the end of definitive design, project costs have increased to the point where it will be classified as a capital asset project. The customer has expressed they want one final total project completion date and will afford no extensions after it is established. How should the risk manager proceed?
-
A
Perform a qualitative risk analysis and update the results.
-
B
Update the assumptions/exclusions register with the new information.
-
C
Update the risk register and prepare for the Monte Carlo analysis.
-
D
Perform a quantitative risk analysis and update the results.
Reveal answer details
Close answer details
Question 93
Single choice
You work as a project manager for BlueWell Inc. Your project is running late and you must respond to the risk. Which risk response can you choose that will also cause you to update the human resource management plan?
-
A
-
B
-
C
-
D
Fast tracking the project
Reveal answer details
Close answer details
Question 94
Single choice
Sammy is the project manager for her organization. She would like to rate each risk based on its probability and affect on time, cost, and scope. Harry, a project team member, has never done this before and thinks Sammy is wrong to attempt this approach. Harry says that an accumulative risk score should be created, not three separate risk scores. Who is correct in this scenario?
-
A
Harry is correct, because the risk probability and impact considers all objectives of the project.
-
B
Harry is correct, the risk probability and impact matrix is the only approach to risk assessment.
-
C
Sammy is correct, because organizations can create risk scores for each objective of the project.
-
D
Sammy is correct, because she is the project manager.
Reveal answer details
Close answer details
Question 95
Single choice
An agriculture government agency faces different challenges with farmers and landlords In implementing its ambitious growth strategy. The agency decided to establish an enterprise risk management unit to identify risks, analyze risks, and provide a handbook showing how to handle the surrounding uncertainty. What should the risk management expert recommend the agency do first to identify risks and develop the handbook?
-
A
Follow standard risk Identification tools dedicated for agriculture and tailor them to the environment.
-
B
Hire an agriculture expert who can develop the required handbook and discuss it with the agriculture minister.
-
C
Prepare a list of the key resources that will be used to compile a risk management plan.
-
D
Conduct meetings, facilitated workshops, and interviews with stakeholders to identify potential risks.
Reveal answer details
Close answer details
Question 96
Single choice
Three months into a program, multiple workstreams are showing issues. At this point, the program manager requires that a risk impact assessment be conducted. What will help calculate the impact?
-
A
-
B
-
C
-
D
Reveal answer details
Close answer details
Question 97
Single choice
A project is underway to implement a new customer support software. During testing, the risk manager discovers that the integration with the existing customer relationship management system is more complex than initially planned, potentially delaying the project. The risk manager needs to update project documents to reflect this new information. Which steps should the risk manager consider when updating relevant project documents?
-
A
Update the issue log with relevant information as the immediate concern for key stakeholders.
-
B
Assume the delay will not affect the timeline and continue with the current scheduled activities.
-
C
Update the project documents after the work has been completed and formally accepted.
-
D
Assess the delay with the technical team, update the schedule and risk register, and inform stakeholders.
Reveal answer details
Close answer details
Question 98
Single choice
Which of the following situational factors has a significant effect on risk attitude?
-
A
The risk heuristics evaluation available to the project team during planning and execution
-
B
The perception of probability or frequency of occurrence and the perception of impact magnitude
-
C
The number of project team members with close relationships to the chief executive officer (CEO)
-
D
The number of external stakeholders and the potential for indirect consequences
Reveal answer details
Close answer details
Question 99
Single choice
Management has asked you to perform a risk audit and report back on the results. Bonny, a project team member asks you what a risk audit is. What do you tell Bonny?
-
A
A risk audit is a review of all the risks that have yet to occur and what their probability of happening are.
-
B
A risk audit is a review of the effectiveness of the risk responses in dealing with identified risks and their root causes, as well as the effectiveness of the risk management process.
-
C
A risk audit is a review of all the risk probability and impact for the risks, which are still present in the project but which have not yet occurred.
-
D
A risk audit is an audit of all the risks that have occurred in the project and what their true impact on cost and time has been.
Reveal answer details
Close answer details
Question 100
Single choice
The risk manager is prioritizing risks based on the potential impact to cost and schedule and identifies the following 4 risks: Risk 1 has a US$500,000 potential cost increase, and a 60 day potential schedule slippage, with a 25% probability of occurring Risk 2 has a US$200,000 potential cost increase, and a 20 day potential schedule slippage, with a 60% probability of occurring Risk 3 has a US$1,200,000 potential cost increase, and a 90 day potential schedule slippage, with a 10% probability of occurring Risk 4 has @ US$600,000 potential cost increase, and a 70 day potential schedule slippage, with a 20% probability of occurring Using expected monetary value calculation, which risk has the greatest potential impact to cost and schedule?
-
A
-
B
-
C
-
D
Reveal answer details
Close answer details
|
